Stage‑gate project governance model

Stage‑gate project governance model

1. What Is the Stage‑Gate Project Governance Model?

The stage‑gate (also called phase‑gate) model is a governance approach that structures projects into a series of stages separated by formal decision points—“gates.” At each gate, a designated governance body reviews evidence against pre‑defined criteria and decides to go (continue and release more funding), kill (stop), hold (pause), or redirect (change scope or approach). Between gates, cross‑functional teams execute the work of the stage and produce the deliverables needed for the next gate review.

Stage‑gate separates doing the work (within stages) from governance and investment decisions (at gates). It clarifies decision rights, improves resource allocation, reduces sunk‑cost bias, and creates an audit trail—especially valuable for complex, cross‑functional, or regulated initiatives.

In plain terms: break big bets into steps, inspect evidence at each step with the right decision‑makers, and deliberately choose to scale, pivot, or stop before spending more time and money.

2. Origin and Background

The stage‑gate process was developed and popularized by Dr. Robert G. Cooper in the 1980s and 1990s for new product development (NPD). Cooper’s research codified the idea of distinct stages (discovery, scoping, business case, development, testing/validation, launch) with gates in between to manage risk and investment. The approach quickly spread beyond consumer goods into pharmaceuticals, industrials, chemicals, and technology, and later into capital projects and public programs. Many firms adapted “Stage‑Gate” (capitalized) as a proprietary system; the generic “stage/phase‑gate” concept is now ubiquitous.

More recently, organizations have modernized stage‑gate to work with Agile/Lean approaches (“Agile‑Stage‑Gate”), risk‑tiering (lighter governance for low‑risk changes), and hypothesis‑based portfolio funding—preserving the governance logic while increasing learning speed.

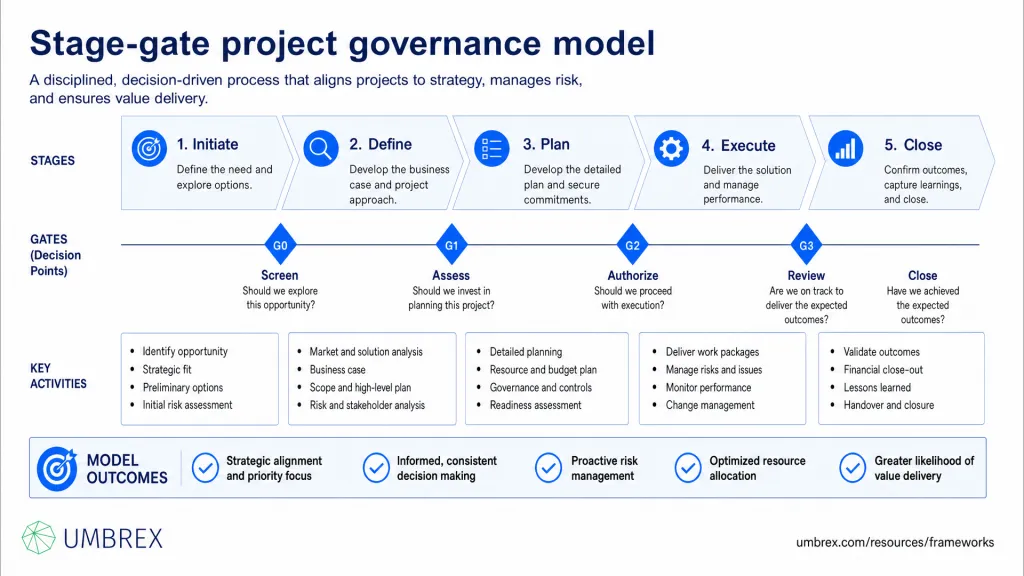

3. How the Stage‑Gate Model Works

Stage-Gate Project Governance Model, specifically how this framework works, including project stages, decision gates, governance reviews, risk assessment, milestone approvals, portfolio management, resource allocation, and project execution.

While terminology varies, most implementations share four design elements: stages, gates, criteria, and decision rights.

Typical Stages

  • Discovery/Ideation: Explore opportunities and problem framing; early voice‑of‑customer.
  • Scoping: Quick assessment of technical/commercial feasibility; initial sizing and risks.
  • Business Case: Deeper validation: value proposition, market sizing, technical options, costs, benefits, risk assessment, regulatory implications.
  • Development: Build solution (hardware/software/process), detailed design, supplier choices, verification plans.
  • Testing & Validation: Technical validation, user trials, regulatory submissions, operational readiness, financial assurance.
  • Launch/Deployment: Market entry or go‑live, change management, support, benefits realization tracking.

Capital and regulatory programs often add stage‑specific gates (e.g., concept select, define/FEED, detailed design, construction, commissioning). Product innovation may use “light”, “standard”, and “express” variants depending on risk and scale.

Gates: The Governance Moments

  • Gate deliverables: Evidence prepared by the project team (requirements, results, financials, risks, test results, regulatory dossiers, readiness checklists).
  • Gate criteria: What the governance body assesses—usually in five buckets:
    • Strategic fit/alignment
    • Value (benefits/cost, business case integrity)
    • Feasibility and risk (technical, regulatory, supply, cyber, operational)
    • Readiness (people, process, tech, suppliers, data, controls)
    • Resource and portfolio impact (capacity, cash, opportunity cost)
  • Gate outputs: A formal decision: Go/Continue (and release next funding tranche); Kill; Hold; Redirect (scope, approach, or risk treatment changes). Actions, owners, and dates are recorded in a decision log.

Decision Rights and Roles

  • Gatekeepers/governing body: Cross‑functional executives who own the decision. Use a single Decider (chair) with clear veto criteria (risk/legal) to avoid deadlock (RAPID/RACI can clarify roles).
  • Project sponsor: Single point of accountability for the outcome; ensures resources and escalations.
  • Project team: Presents evidence; proposes options; executes stages.
  • Challenge/assurance functions: Risk, compliance, finance, security/clinical/quality provide independent challenge and verification where required (for high‑risk gates, add Verify/Sign‑off roles).

Funding and Portfolio Integration

Funding is released in tranches at gates, based on evidence. Portfolio management uses gates to balance the mix of projects (innovation horizons, risk/return, capacity), kill weak bets early, and prioritize scarce resources toward the highest value and feasibility.

Variants and Modern Enhancements

  • Risk tiering: Lighter, faster gates for low‑risk changes; heavier assurance only for high‑risk items with explicit criteria (impact, regulatory exposure, customer data/safety, spend).
  • Agile‑Stage‑Gate: Inside “Development” and “Validation” stages, teams run Agile sprints; gate reviews focus on objective evidence (working increments, customer signals) rather than paper plans.
  • Hypothesis‑based gates: Each stage articulates testable hypotheses (“If we do X, metric Y moves by Z”); gates evaluate learnings vs. hypotheses to decide next bets.
  • Policy‑as‑code checks: Automate standard checks (security, quality, SLO impact) to reduce manual gatekeeping; reserve human reviews for exceptions.

4. When to Use Stage‑Gate

Stage-Gate Project Governance Model, specifically when to apply this framework, including new product development, innovation management, capital projects, technology implementation, R&D programs, portfolio governance, strategic initiatives, and project management.

Most helpful when:

  • Projects are cross‑functional, high‑stakes, or regulated (pharma/med‑tech, financial services, energy, public infrastructure).
  • Investment and capacity must be sequenced and risk‑managed across a portfolio.
  • Boards or regulators require auditability of decisions and evidence‑based oversight.
  • Past initiatives suffered from scope creep, weak business cases, or “finish‑at‑any‑cost” behavior.

Especially powerful: New product development, capital programs, clinical/regulated launches, enterprise platform modernization (e.g., ERP/CRM/core banking), and market entry programs.

Less suitable or potentially misleading:

  • Highly exploratory, fast‑pivot contexts where the goal is discovery rather than staged delivery (use Lean Startup/Discovery first, then add light gates).
  • Continuous delivery of small increments (DevOps/SRE) where automated policy and service‑level guardrails outperform heavy paper gates.
  • When gates become status theater or compliance rituals without real decisions.

5. How to Apply Stage‑Gate: Step‑by‑Step

Stage-Gate Project Governance Model, specifically how to apply this framework, including defining project stages and decision gates, establishing governance criteria, conducting milestone reviews, evaluating risks and business cases, approving progression, and improving project delivery through structured governance.

  1. Clarify objectives and scope.

    Why adopt stage‑gate (e.g., “Increase kill rate of low‑value projects by 30% within 2 gates; reduce overruns by 40%; improve auditability”)? Define scope: portfolio, program, or project types (innovation, capex, tech transformation).

  2. Design the stage model (with variants).

    Define 4–6 stages appropriate to your domain. Create variants by risk/complexity (e.g., Lite/Standard/Heavy). Document stage purposes, typical activities, and expected evidence.

  3. Define gates, criteria, and decision rights.

    For each gate:

    • List required deliverables/evidence (scaled by variant).
    • Write decision criteria (fit, value, risk/feasibility, readiness, resource/portfolio impact).
    • Map roles using RAPID/RACI (single Decider; who has narrow veto and on what basis; who verifies; who signs off when required).
    • Set SLAs: Input windows (e.g., 3–5 business days), challenge/veto (24–48 hours with written citations), and escalation paths.

    Provide scorecards or checklists to drive consistent decisions.

  4. Integrate funding and portfolio management.

    Tie gate “Go” to the release of the next funding tranche. Use portfolio forums to rebalance capacity based on gate outcomes. Make kill/redirect decisions visible and celebrated to reduce sunk‑cost bias.

  5. Instrument evidence and automate checks.

    Define sources of truth: financials, risk registers, test/validation results, SLOs, security/privacy checks. Automate standard verifications (policy‑as‑code) where possible; require human review only for high‑risk gates and exceptions.

  6. Stand up decision forums and cadence.

    Schedule concise gate reviews (30–90 minutes) by gate type. Use short decision briefs (2–4 pages) focusing on options, evidence, risks, and asks. Keep a decision log (decision, rationale, conditions, owners).

  7. Pilot with 3–5 projects and tune.

    Run a pilot cycle across different risk tiers. Inspect bottlenecks, criteria clarity, and evidence quality. Simplify deliverables; tighten veto criteria and SLAs; add or remove checks as needed.

  8. Train roles and embed behaviors.

    Coach gatekeepers on evidence‑based decisions; train teams on preparing decision briefs; align incentives (recognize kills/pivots, not just launches). Clarify that gates are decision points, not status updates.

  9. Measure and improve.

    Track cycle time from submission to gate decision, percent of Go/Kill/Hold/Redirect, rework rate between gates, forecast accuracy, audit findings, and benefits realized post‑launch. Review quarterly and refine the model.

6. Example: Stage‑Gate in a Med‑Tech Software‑Enabled Device Launch

Context: A 6,500‑employee med‑tech company planned a Class II device with embedded software and cloud telemetry. Previous launches suffered from late regulatory surprises and post‑launch reliability incidents. Leadership instituted a risk‑tiered stage‑gate with Agile inside Development and Validation.

Stages and gates (Standard variant): Discovery → Scoping (Gate 1) → Business Case (Gate 2) → Development (Gate 3) → Validation & Submission (Gate 4) → Launch (Gate 5). High‑risk changes also required a “Quality Release” sign‑off.

Gate criteria highlights:

  • Gate 2 (Business Case): Strategic fit; clinical need validation; preliminary usability/risk analysis; architecture options; make/buy analysis; high‑level cost/benefit; privacy/security threat model.
  • Gate 3 (Development): Detailed design plan; sprint plan; verification protocol; supplier qualification; regulatory strategy confirmed; quality system alignment; SLO targets for cloud services.
  • Gate 4 (Validation & Submission): Verification/validation results; cybersecurity testing; human factors studies; regulatory dossier readiness; manufacturing readiness; support model; field training plan.
  • Gate 5 (Launch): Regulatory approvals; operational readiness; SLAs/SLOs met in pilot; adverse event processes; benefits tracking plan.

Decision rights: Single Decider (GM). Narrow veto: Regulatory Affairs (dossier adequacy), Quality (QMS compliance), Privacy/Security (policy breaches). Verify: independent QA for validation results; Sign‑off: Quality Release for high‑risk changes. SLAs: Input 5 days; veto 48 hours with citations; escalations to COO within 24 hours.

Execution approach: Agile sprints within Development and Validation produced working increments and telemetry; policy‑as‑code checks in CI/CD enforced security baselines and SLO impact gates.

Outcomes (two gates, ~16 weeks): Two supplier paths killed early (supply risk); architecture locked with reusable components; no late regulatory surprises; forecast variance reduced by 35%; pilot SLO attainment ≥99.95%; total program timeline risk reduced by ~12 weeks. Post‑launch complaint rates were 28% lower than prior comparable launches.

7. Strengths and Limitations

Strengths

  • Clarity and discipline: Explicit decision points, owners, and criteria reduce ambiguity and drift.
  • Better capital allocation: Funding in tranches based on evidence raises portfolio returns and slows sunk‑cost escalation.
  • Risk management: Early termination or redirection of weak bets; assurance steps for high‑risk items.
  • Auditability: Documented decisions and evidence support regulatory and Board oversight.

Limitations

  • Bureaucracy risk: Over‑engineering deliverables and checks slows learning and delivery.
  • False certainty: Paper evidence can obscure reality if not anchored in objective tests/telemetry.
  • Agile friction: Heavy, serial gates can clash with iterative delivery if not adapted.
  • Behavioral pressure: Teams may “sell” at gates; governance must reward killing/redirecting as success.

8. Common Pitfalls (and How to Avoid Them)

  • Gate sprawl.
    What goes wrong: Too many gates and artifacts; slow decisions.
    Avoid by: Limiting to 4–6 gates; scaling deliverables by risk; automating standard checks.
  • Rubber‑stamp gates.
    What goes wrong: No real challenge; weak projects drift on.
    Avoid by: Assigning a single Decider, formalizing veto criteria, and requiring options with evidence—Go/Kill/Redirect as default, not passive Go.
  • Unclear decision rights.
    What goes wrong: Looping approvals; shadow vetoes.
    Avoid by: Using RAPID/RACI; narrow, policy‑bound veto; SLAs and escalation rules.
  • Paper over practice.
    What goes wrong: Beautiful decks, poor outcomes.
    Avoid by: Requiring objective evidence (working increments, tests, telemetry, pilots) and independent verification for high risk.
  • One‑size‑fits‑all.
    What goes wrong: Low‑risk items over‑governed; high‑risk under‑governed.
    Avoid by: Risk tiering with explicit criteria; scale gates and assurance accordingly.
  • Gates as status meetings.
    What goes wrong: Time spent reporting, no decisions.
    Avoid by: Short decision briefs, pre‑reads, decision logs, and time‑boxed forums focused on options and outcomes.
  • No benefits tracking post‑launch.
    What goes wrong: Value assumptions untested; learnings lost.
    Avoid by: Making benefits realization part of Gate 5 and beyond; review in quarterly performance dialogues.

9. How Stage‑Gate Relates to Other Frameworks

  • Portfolio Management: Stage‑gate provides project‑level go/kill decisions; portfolio management allocates capacity across the funnel. Use together to rebalance quarterly.
  • RAPID/RACI: Clarify gate decision roles—single Decider, narrow Agree (veto), Input contributors, Perform (execution). Avoid multiple decision‑makers.
  • PMI/PRINCE2: Both include phase boundaries and governance; stage‑gate can be the governance overlay across these delivery methods.
  • Agile/DevOps/SRE: Embed Agile sprints within stages; replace paper gates with objective evidence (working increments, SLOs, automated checks). Reserve human gates for high‑risk decisions.
  • Lean Startup/Discovery: Use discovery experiments before Gate 2/3 to validate problem/solution fit; transition to stage‑gate once hypotheses begin to harden.
  • Quality/Regulatory (e.g., FDA Design Controls, ISO 13485): Map gates to mandated reviews and sign‑offs; use Verify/Sign‑off roles for independence and compliance.
  • Technology Readiness Levels (TRLs): TRLs can inform gate criteria for technical maturity, especially in aerospace/defense and deep tech.
  • Three Lines Model: First line (project) owns risk/controls; second line (risk/compliance) challenges/monitors; third line (audit) assures—especially at high‑risk gates.

10. Key Takeaways

  • Stage‑gate divides projects into stages with formal go/kill/hold/redirect decisions at gates, based on evidence and clear criteria.
  • Design gates with a single Decider, narrow veto criteria, SLAs, and decision logs; scale deliverables and assurance by risk.
  • Integrate with portfolio funding: release capital in tranches; kill weak bets early; reallocate capacity to the highest value opportunities.
  • Modernize with Agile inside stages, hypothesis‑based criteria, and automated checks; reserve heavy human gates for high‑risk items.
  • Measure decision speed, kill/redirect rates, forecast accuracy, audit findings, and post‑launch benefits; refine quarterly.

11. FAQs About the Stage‑Gate Model

Is stage‑gate outdated in an Agile world?
No—when modernized. Use stage‑gate for governance (investment and risk decisions) and Agile for delivery within stages. Replace static documents with objective evidence (working software, test data, telemetry). Risk‑tier and automate standard checks.

How many stages and gates do we need?
Typically 4–6 stages and 4–6 gates. Fewer for low‑risk or incremental changes; more for complex, regulated programs. Start lean and add only where risk justifies.

Who should be the gatekeepers?
A cross‑functional governance body with a single Decider (chair) and narrowly defined veto roles (e.g., legal/regulatory). Include finance (value), risk/compliance (assurance), and domain leads. Keep the group small and empowered.

How long should gate reviews take?
The review meeting is usually 30–90 minutes per gate. The cycle from submission to decision should be SLA‑bound (e.g., ≤10 business days) with pre‑reads and “silence = no objection” for advisory inputs.

What criteria should we use at gates?
Balance strategic fit, value (benefits/cost), feasibility and risk (technical, regulatory, supply, cyber, operational), readiness (people/process/tech/suppliers/data/controls), and resource/portfolio impact. Tailor by stage and risk tier.

Can we automate gate checks?
Yes. Automate standard verifications (security baselines, SLO impact, coding standards, privacy checks) as policy‑as‑code, and require human reviews only for exceptions and high‑risk gates.

How do we avoid rubber‑stamping?
Name a single Decider; require options and objective evidence; define narrow veto criteria; track kill/redirect rates; and celebrate well‑governed kills as success.

How does stage‑gate handle benefits realization?
Make benefits tracking part of the final gate and post‑launch plan; review benefits quarterly; adjust or sunset underperforming initiatives; recycle learnings into criteria.

What tools do we need?
Start with standard decision brief templates, a decision log, and dashboards (value, risk, readiness). As you mature, integrate with portfolio tools, GRC/assurance systems, and CI/CD pipelines for automated checks.

How to get started

1

arrow-down-blue

Tell us about your project

2

arrow-down-blue

Interview candidates

(We’ll provide bios within 48 hours on average)

3

Select your consultant and start work

Find a Consultant

or email us at: [email protected]
