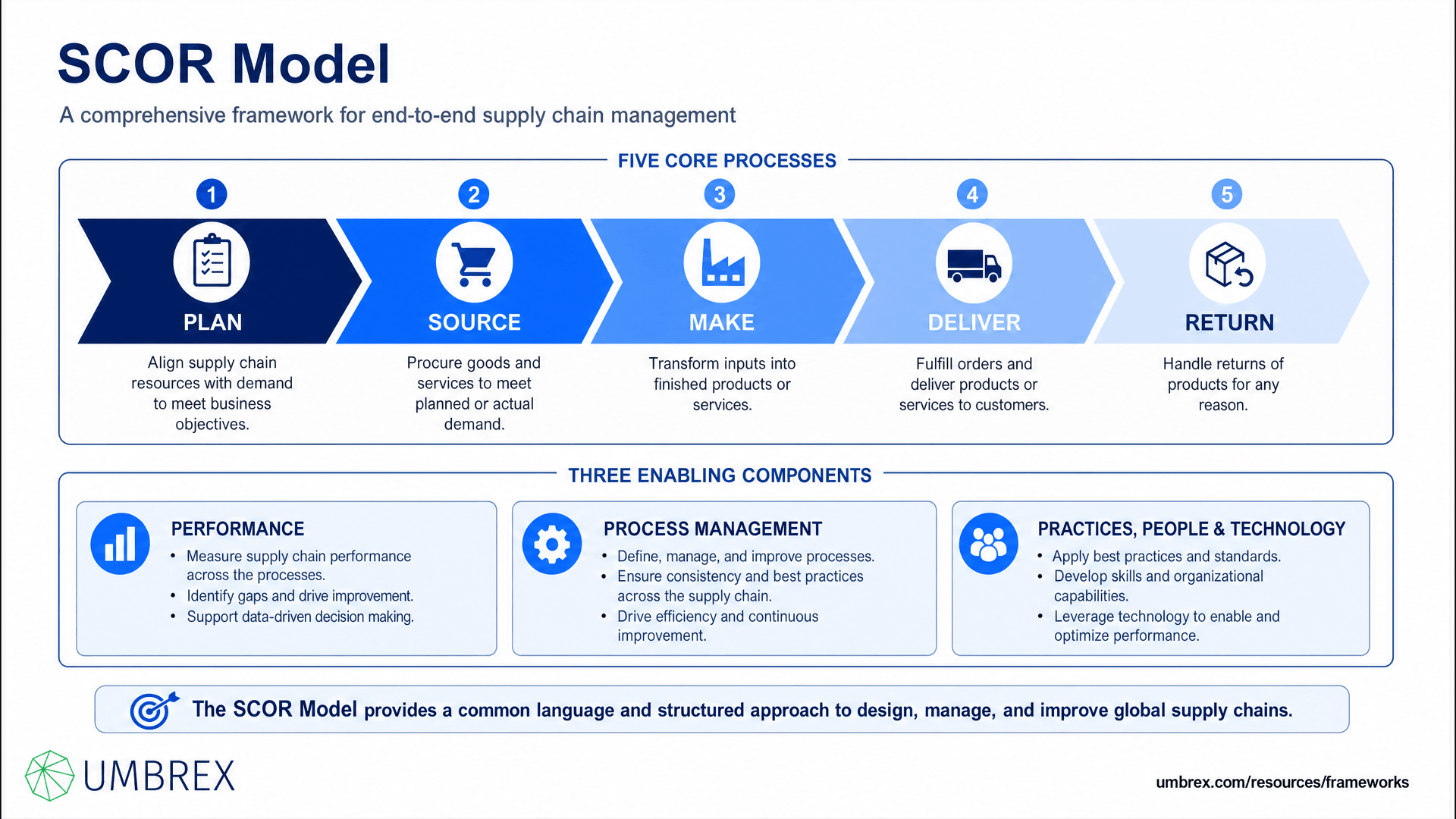

SCOR Model

1. What Is SCOR Model?

SCOR Model, specifically how this framework works, including supply chain planning, sourcing, manufacturing, delivery, returns, supply chain processes, performance measurement, process standardization, operational excellence, and supply chain optimization.

The SCOR Model (Supply Chain Operations Reference) is a standardized framework for describing, measuring, and improving end‑to‑end supply chain performance. It provides a common language for processes, metrics, and best practices across the core areas of a supply chain—Plan, Source, Make, Deliver, Return—with Enable processes supporting them. SCOR links what you do (process), how you measure it (KPIs), and how you improve it (practices and capabilities).

In plain terms: SCOR lets you baseline how your supply chain works today, compare performance to peers, design a “to‑be” model, and prioritize initiatives that move headline metrics such as perfect order fulfillment, order cycle time, total cost, and cash‑to‑cash. Because it is process‑ and metric‑centric, SCOR creates a shared operating model across business units, regions, and functions—and integrates naturally with Lean, Six Sigma, TOC, and S&OP/IBP programs.

Executives and consultants use SCOR to drive operating excellence, digital transformations, network redesigns, and integration after M&A. It is industry‑agnostic and applicable to both product‑centric and service‑heavy supply chains.

2. Origin and Background

SCOR was launched in 1996 by the Supply‑Chain Council (SCC) as a cross‑industry standard to harmonize supply chain processes and metrics. The framework has been updated repeatedly (e.g., SCOR v12.0) and is now stewarded by APICS/ASCM (Association for Supply Chain Management) after SCC’s merger. Modern iterations add digital enablers, sustainability considerations, and skills/competency models.

Why it was created: companies lacked a shared vocabulary and comparable KPIs. SCOR provided a reference architecture—process hierarchy, standard metrics, and best practices—so organizations could benchmark, align, and improve systematically rather than reinventing definitions locally.

How it became known: through wide adoption by global manufacturers, retailers, logistics providers, and consulting practices; formal certifications (e.g., SCOR‑P); and benchmarking tools (e.g., SCORmark) promoted by SCC/ASCM.

3. How the SCOR Model Works

SCOR (Supply Chain Operations Reference) Model, specifically how this framework works, including Plan, Source, Make, Deliver, Return, Enable, supply chain processes, performance metrics, benchmarking, and continuous improvement.

SCOR organizes supply chain work into repeatable building blocks and connects them to performance attributes and metrics.

Process architecture

  • Level 1 (Process types): Plan, Source, Make, Deliver, Return, Enable.
  • Level 2 (Process categories): e.g., Plan supply chain, Source stocked product, Make‑to‑order, Deliver e‑commerce orders, Return defective product, Enable data/technology/skills.
  • Level 3 (Process elements): detailed activities, inputs/outputs, and performance metrics—for example, S1.1 “Schedule Product Deliveries,” M2.3 “Schedule Production Activities.”

Six core process areas

  • Plan: balance demand and supply, S&OP/IBP, inventory targets, capacity planning, performance monitoring.
  • Source: procure goods/services, schedule deliveries, receive/verify, supplier collaboration.
  • Make: produce/repair/remanufacture, schedule, transform, test, package, release.
  • Deliver: order management, warehouse, transportation, last‑mile, export/compliance, invoicing.
  • Return: reverse logistics for defective/unused products, RMA processing, refurbish/recycle.
  • Enable: governance, master data, technology, cybersecurity, facilities, HR/skills, sustainability, compliance—capabilities that make Plan/Source/Make/Deliver/Return work.

Performance attributes and Level‑1 metrics

  • Reliability: do we do what we promised? Metric: Perfect Order Fulfillment.
  • Responsiveness: how quickly do we fulfill? Metric: Order Fulfillment Cycle Time.
  • Agility: how well do we respond to change? Metrics: Upside Supply Chain Flexibility/Adaptability, Downside Adaptability.
  • Cost: what does it cost to operate? Metric: Total Supply Chain Management Cost.
  • Asset Management Efficiency: how well do we use capital? Metrics: Cash‑to‑Cash Cycle Time, Return on Fixed Assets, Inventory Days of Supply.

Metrics hierarchy

  • Level 1: headline KPIs across the whole chain.
  • Level 2–3: diagnostic KPIs tied to specific processes (e.g., forecast accuracy, supplier on‑time, schedule adherence, pick accuracy, fleet utilization, RMA cycle time).

Best practices and enablers

  • SCOR catalogs practices linked to metrics improvement (e.g., collaborative planning, constraint‑based scheduling, postponement, VMI/consignment, TMS optimization, quality at source) with typical technology enablers and organizational prerequisites.

Unlike a generic process map, SCOR gives you a standardized comparison set and a line‑of‑sight from process to metric to improvement lever—so you can both benchmark and design to a target state.

4. When to Use the SCOR Model

SCOR (Supply Chain Operations Reference) Model, specifically when to apply this framework, including supply chain transformation, operations management, logistics optimization, procurement, manufacturing, distribution, performance benchmarking, and end-to-end supply chain improvement.

Most helpful for:

  • Operating model redesign: aligning global plants/DCs under one process/metric framework; harmonizing after M&A.
  • Performance turnarounds: poor service, high cost, bloated inventory; need a fact‑based baseline and roadmap.
  • Digital transformation: selecting technologies by process need (demand planning, WMS/TMS, APS, control towers) rather than “tool first.”
  • Benchmarking and target setting: objective comparison to peers/industry using standard definitions.
  • S&OP/IBP integration: linking Plan to execution processes and metrics.

Especially powerful when:

  • You operate across multiple countries/sites/channels and need a common language and KPI set.
  • You must prioritize investments across many potential initiatives and quantify impact on headline metrics.

Less effective or potentially misleading when:

  • Used as a paperwork exercise without data or action; mapping for mapping’s sake.
  • Imposed dogmatically; SCOR is a reference, not a straitjacket—adapt to your context (e.g., configure‑to‑order vs. make‑to‑stock).
  • Metrics are localized/inconsistent; if definitions differ, benchmarking and targets become meaningless.

Practice evolution: Organizations extend SCOR with sustainability (Scope 1–3 emissions by process), risk/resilience (dual sourcing, buffers, time‑to‑recover), and digital signals (IoT/telemetry, control towers) while keeping the core process/metric framework intact.

5. How to Apply the SCOR Model: Step‑by‑Step

SCOR (Supply Chain Operations Reference) Model, specifically how to apply this framework, including mapping end-to-end supply chain processes, assessing performance using SCOR metrics, identifying operational gaps, benchmarking against best practices, prioritizing improvement initiatives, and continuously optimizing supply chain performance.

  1. Clarify scope and objectives

    Define the enterprise boundary (end‑to‑end, a region, a business unit) and what success looks like in SCOR terms (e.g., Perfect Order +6 pts, Order Cycle Time −30%, Cash‑to‑Cash −20 days, SCM cost −8%). Decide time horizon and whether the first pass is diagnostic or design.

  2. Map the value chain to SCOR

    Identify major flows and classify at Level 1–2: Plan, Source (stocked/engineered), Make (MTS/MTO/ATO/ETO), Deliver (to DC, store, e‑commerce), Return (MRO, reverse), and Enable functions. Build a high‑level SCOR topology (nodes, modes, decoupling points, postponement).

  3. Baseline performance with standard metrics

    Collect Level‑1 metrics with common definitions:

    • Reliability: Perfect Order Fulfillment (on‑time, complete, damage‑free, correct documentation).
    • Responsiveness: Order Fulfillment Cycle Time (customer order to delivery).
    • Agility: Upside/Downside Adaptability, Flexibility (how much you can ramp in X days).
    • Cost: Total SCM Cost (plan+source+make+deliver+return+overheads).
    • Asset: Cash‑to‑Cash (DSO + DIO − DPO), ROFA, Inventory DOS.

    Add Level‑2 diagnostics (forecast accuracy, schedule adherence, pick accuracy, carrier OTIF). Where possible, use external benchmarks (industry quartiles) to contextualize gaps.

  4. Diagnose gaps and root causes

    Link underperforming metrics to Level‑2/3 processes. For example, low reliability → order promise logic, supplier OTIF, warehouse accuracy; long cycle time → planning latency, batching, capacity constraints, transport tendering delays; high cash‑to‑cash → safety stock policy, slow‑moving inventory, DSO practices.

  5. Design the target (to‑be) SCOR processes

    Define future processes by area:

    • Plan: implement IBP cadence, constraint‑aware planning, segmentation; connect demand sensing to short‑term scheduling.
    • Source: supplier segmentation, SRM, VMI/consignment, lead time/agreement redesign, dual sourcing.
    • Make: flow lines/cells, changeover reduction, finite scheduling, quality at source, postponement.
    • Deliver: inventory placement, WMS/TMS optimization, slotting, pick‑to‑light/voice, dynamic routing, last‑mile models.
    • Return: RMA process, refurbishment, circular flows.
    • Enable: master data governance, control tower, analytics, skills, cybersecurity, ESG reporting.

    Quantify expected impact on Level‑1 metrics.

  6. Prioritize initiatives and build the roadmap

    Create a portfolio with impact vs. effort/risk. Sequence “no‑regrets” fixes (data, master scheduling, warehouse accuracy) and lighthouse digital enablers (WMS/TMS, APS, control tower). Align with capital and capability constraints; set 90‑day deliverables.

  7. Install governance and measurement

    Adopt SCOR KPIs in management routines. Create a cadence (weekly operational, monthly S&OP/IBP, quarterly strategy). Standardize metric definitions in a data dictionary. Make site/regional dashboards roll up to enterprise Level‑1 metrics with drill‑downs.

  8. Execute, learn, and iterate

    Run pilots, verify metric movement, scale. Refresh the SCOR model annually or after major network/portfolio changes. Keep the Enable layer funded (skills, master data, integration) to sustain gains.

6. Example: SCOR in Action

Context: “ElectraHome,” a $4.5B consumer electronics company, operated nine factories and 18 DCs globally. Despite strong demand, it suffered Perfect Order of 83%, order cycle times of 14.8 days, cash‑to‑cash of 92 days, and high expedite costs. Leadership launched a SCOR‑based transformation to improve service and free cash.

Baseline (Level‑1)

  • Reliability: Perfect Order 83% (peer median 92%).
  • Responsiveness: Order Fulfillment Cycle Time 14.8 days (peer 9–10).
  • Agility: Upside flexibility +15% in 30 days (peer +25%).
  • Cost: Total SCM Cost 10.9% of revenue (peer 8.5–9.5%).
  • Asset: Cash‑to‑Cash 92 days (DSO 38, DIO 78, DPO 24).

Diagnostics

  • Plan: weak IBP; weekly batch planning; low forecast accuracy for promo SKUs.
  • Source: single‑source components with 14–18 week lead times; no SRM escalation protocols.
  • Make: long changeovers; schedule adherence 76%; quality escapes causing rework.
  • Deliver: pick accuracy 98.4% (below top quartile); carrier tendering delays; poor slotting for fast‑movers.
  • Enable: inconsistent master data; limited real‑time visibility.

To‑be design & initiatives

  • Plan: instituted monthly IBP; demand segmentation; constraint‑based finite scheduling; short‑term demand sensing for top SKUs.
  • Source: dual‑sourced two critical chips; VMI for top 50 components; supplier scorecards and QBRs; MOQ/lead‑time renegotiation.
  • Make: SMED program (−45% changeover on two lines); first‑pass yield +2.5 pts; schedule adherence > 90% through daily tier huddles.
  • Deliver: WMS upgrades with slotting optimizer; pick‑to‑light in two DCs; TMS with dynamic routing; order promise logic updated to ATP/CTP.
  • Enable: control tower for E2E visibility; master data governance; skills upgrade (SCOR‑P training).

Outcomes (12 months)

  • Perfect Order 83% → 93%; Order Cycle Time 14.8 → 9.6 days.
  • Total SCM Cost −170 bps; Cash‑to‑Cash 92 → 68 days (DIO −16, DSO −6, DPO +2).
  • Expedite cost −38%; inventory write‑offs −22%; customer NPS +7 pts.
  • Agility: upside flexibility +26% in 30 days; service maintained through a supplier disruption due to dual sourcing and inventory segmentation.

Why it worked: standard SCOR metrics revealed where the system lagged; initiatives were prioritized against headline KPIs; Enable investments (data, skills, control tower) made improvements stick across regions and sites.

7. Strengths and Limitations

Strengths

  • Common language: Aligns cross‑functional teams on process definitions and KPI formulas—essential for global scale.
  • Benchmarkable: Standard metrics enable peer comparisons and realistic target setting.
  • End‑to‑end line of sight: Connects Plan–Source–Make–Deliver–Return with Enable capabilities; clarifies trade‑offs (service, cost, cash).
  • Actionable: Links metrics to best practices and technology enablers—useful for roadmaps and business cases.

Limitations

  • Abstraction risk: If applied mechanically, SCOR can become documentation rather than change—requires strong governance and data.
  • Not prescriptive on network design: SCOR frames processes/metrics; you still need detailed analytics for footprint and policy design.
  • Customization needed: Niche or highly regulated industries may need adaptations (e.g., serialization, cold chain, clinical trials).
  • Metric gaming: Without robust definitions and cross‑checks, local optimizations can distort enterprise performance.

8. Common Pitfalls (and How to Avoid Them)

  • Inconsistent metric definitions
    What goes wrong: Apples‑to‑oranges comparisons; misleading dashboards.
    How to avoid: Publish a data dictionary; audit metric calculations; use one source of truth.
  • Process mapping without action
    What goes wrong: Large binders and no performance change.
    How to avoid: Tie each gap to a specific initiative with impact on Level‑1 metrics and an owner.
  • Tech purchases not linked to SCOR gaps
    What goes wrong: Tools don’t move KPIs.
    How to avoid: Select enablers only when linked to a targeted process and metric improvement.
  • Ignoring the Enable layer
    What goes wrong: Process designs fail for lack of master data, skills, or governance.
    How to avoid: Fund data/skills/cyber initiatives in the roadmap; make them prerequisites.
  • One‑size‑fits‑all processes
    What goes wrong: Over‑standardization hurts segments requiring different service/cost profiles.
    How to avoid: Segment by product/market; tailor policies (e.g., inventory, promise) within a SCOR framework.
  • Underestimating change management
    What goes wrong: Sites revert to old ways; KPIs drift.
    How to avoid: Governance cadences (tier meetings, S&OP), capability building, incentives tied to SCOR metrics.

9. How SCOR Relates to Other Frameworks

  • S&OP/IBP: Operates within SCOR’s Plan processes; SCOR provides downstream execution alignment and KPIs.
  • Lean / Six Sigma / TOC: SCOR identifies where to apply Lean (waste removal), Six Sigma (variation reduction), and TOC (constraint focus) to move specific SCOR metrics.
  • Value Stream Mapping (VSM): VSM gives time‑ and WIP‑based flow detail within a SCOR process; use together to design improvements.
  • APQC PCF / ISO 9001: PCF offers a broad enterprise process taxonomy; SCOR goes deeper on supply chain with metrics and practices. ISO provides quality system requirements; SCOR maps to operational execution.
  • DDMRP / Inventory Optimization: Policy frameworks that can be deployed within SCOR Plan/Source/Make/Deliver to improve responsiveness and cash.
  • Digital Twins / Control Towers: Enablers in SCOR’s Enable layer that improve sensing, decisioning, and execution against SCOR KPIs.

10. Key Takeaways

  • SCOR provides a standard process and metric framework across Plan–Source–Make–Deliver–Return–Enable.
  • Use SCOR to baseline, benchmark, and design your supply chain, then prioritize initiatives that move Level‑1 KPIs (service, speed, agility, cost, cash).
  • Make metric definitions non‑negotiable; adopt a single data dictionary and governance cadence.
  • Fund the Enable layer (data, skills, systems); it is the scaffolding for sustainable performance.
  • Combine SCOR with S&OP/IBP, Lean/Six Sigma/TOC, and digital enablers to translate design into measurable results.

11. FAQs About SCOR Model

What is the difference between SCOR and APQC’s Process Classification Framework (PCF)?
PCF is a general enterprise taxonomy. SCOR is specific to supply chains and goes deeper with standard metrics, best practices, and a process hierarchy tailored to Plan–Source–Make–Deliver–Return–Enable. Many firms use PCF at the top level and SCOR for supply chain detail.

Is SCOR still relevant with modern digital tools?
Yes. SCOR tells you what to fix and how to measure it; digital tools (APS, WMS/TMS, control towers, AI) are enablers deployed where SCOR gaps exist. SCOR’s latest versions explicitly include digital and skills in the Enable layer.

How long does a SCOR assessment take?
A rapid baseline for one region or BU can be done in 4–6 weeks (mapping, Level‑1 metrics, gap analysis). A global design and roadmap typically spans 8–12 weeks, with execution in waves over 6–18 months depending on scope.

What data is required?
For Level‑1: order lines and promise/ship data, inventory and financials (DSO/DIO/DPO), cost by process area. For diagnostics: forecast accuracy, schedule adherence, supplier/carrier OTIF, pick accuracy, yields, capacity, lead times. Standardize definitions before comparing sites.

What’s the difference between Return and Reverse Logistics?
In SCOR, Return covers all reverse flows (customer returns, repairs, recalls, end‑of‑life, supplier returns). Reverse logistics is the execution domain within Return (transport, triage, disposition).

How does SCOR handle services?
Service supply chains (parts, field service, e‑commerce, health care) map well: Plan (capacity and spares), Source (service parts), Make (repair/refurbish), Deliver (field dispatch), Return (cores/defective), Enable (knowledge, scheduling, platforms). Metrics remain applicable (reliability, cycle time, cost, asset usage).

Can SCOR improve sustainability metrics?
Yes. Embed emissions and waste metrics per process (e.g., transport CO₂ per shipment, energy per unit in Make), then prioritize practices (network design, modal shifts, packaging, circular returns) to meet ESG targets without sacrificing SCOR performance.

Do we need SCOR certification?
Not required, but SCOR‑P training accelerates adoption and consistency, especially in global programs. The bigger the footprint, the more helpful a common training baseline.

How to get started

1

arrow-down-blue

Tell us about your project

2

arrow-down-blue

Interview candidates

(We’ll provide bios within 48 hours on average)

3

Select your consultant and start work

Find a Consultant

or email us at: [email protected]
