Project Portfolio Management (PPM)

Project Portfolio Management (PPM)

1. What Is Project Portfolio Management (PPM)?

Project Portfolio Management (PPM) is the discipline of selecting, funding, and governing a coordinated set of projects and programs to maximize enterprise value under strategic, financial, and capacity constraints. It treats change initiatives as a portfolio of investments—prioritized, sequenced, and actively rebalanced—rather than as a loose collection of standalone projects.

In practical terms, PPM aligns initiatives to strategy, evaluates value and risk, allocates scarce resources (people and capital), and manages interdependencies. It creates a transparent, data-informed way to choose the “few, big, important” bets, stop or reshape lower-value work, and ensure execution capacity matches ambition.

Within the Project Management function under “Portfolio, Strategy & Governance,” PPM is a strategic and governance framework. It is widely used by consultants and senior executives to translate strategy into execution, improve return on change spend, and provide a single source of truth for decision-making across business, technology, and finance.

2. Origin and Background

Origin: Unknown; in use since at least the 1990s.

PPM draws on ideas from financial portfolio theory (balancing risk and return), corporate strategy (resource allocation), and program/project management. In the 1990s, portfolio thinking moved into product development and IT: Robert Cooper and colleagues popularized portfolio decision methods for new product development, while enterprise IT adopted PPM to rationalize project demand. Formal codification accelerated in the 2000s with standards such as PMI’s Standard for Portfolio Management and widespread adoption of PPM software platforms.

PPM arose to solve a persistent problem: organizations launched too many initiatives for the available capacity, scattered funding thinly, and struggled to connect projects to strategy. PPM provided a repeatable approach to pick better bets, stop weaker ones, and steer execution with evidence rather than opinion.

3. How Project Portfolio Management (PPM) Works

Project Portfolio Management (PPM), specifically how this framework works, including portfolio governance, project prioritization, strategic alignment, resource allocation, investment management, risk balancing, portfolio optimization, and performance monitoring.

PPM applies investment discipline to change. Its core logic: make strategy explicit, quantify value and risk, respect real capacity constraints, and revisit choices frequently as conditions change. The operating model typically includes the following components.

Core Components

  • Demand intake and triage: A single front door for ideas and requests (projects, epics, enhancements). Standardized submissions capture business outcomes, cost, timing, dependencies, and risk/regulatory context.
  • Evaluation and prioritization: A scoring model combines strategic alignment, value (e.g., NPV, revenue uplift, cost-out), risk/complexity, urgency (e.g., regulatory deadlines), and dependencies. Qualitative assessments complement quantitative estimates to avoid false precision.
  • Selection and sequencing: Scenario analysis chooses a set of initiatives that maximizes value within constraints (budget, talent, vendor bandwidth, environments). Sequencing reduces contention for scarce resources and respects critical dependencies.
  • Capacity and resource management: Realistic supply-demand matching for key skills and teams. Moves from “100% utilization” myths to pragmatic throughput and WIP limits, especially in knowledge work.
  • Funding and governance: Guardrails define who decides what, when (e.g., quarterly portfolio reviews). Many organizations shift from annual, project-based funding to rolling, product/value-stream budgets with evidence-based tranches.
  • Delivery oversight and benefits tracking: Portfolio health dashboards show schedule, spend, risk, dependencies, and outcomes (benefits realized, customer impact). Decisions to continue, pivot, or stop are based on objective signals.
  • Adaptive rebalancing: Periodic (often quarterly) replans incorporate new information—market shifts, delivery velocity, benefit signals—and adjust the portfolio mix accordingly.

Typical Artefacts and Analyses

  • Portfolio Kanban/funnel: Visualizes intake through stages—idea, assessment, business case, approved, in-delivery, done.
  • Prioritization matrix and bubble charts: Plots value versus risk/complexity; bubble size may reflect investment, color the strategic theme; highlights trade-offs and diversification.
  • Roadmaps and sequencing plans: Communicate when initiatives start/finish, key dependencies, and capacity consumption over time.
  • Scenario and sensitivity analysis: “What if” views under budget cuts, talent constraints, or accelerated timelines; helps choose a robust plan.
  • Benefits realization plans: Make benefits explicit (owners, baselines, measurement), linking delivery milestones to outcome metrics.

Governance Roles (illustrative)

  • Executive portfolio board (or investment committee): Approves strategy-aligned themes, funding envelopes, and major decisions; arbitrates trade-offs.
  • Portfolio manager (or PMO/Value Office lead): Orchestrates intake, analysis, planning, reporting, and rebalancing; ensures a single source of truth.
  • Value-stream/product owners (or business sponsors): Articulate outcomes, own benefits, and steward delivery trade-offs within their envelope.
  • Finance partner: Validates business cases, tracks benefits realization, and oversees rolling funding processes.
  • Architecture/operations leaders: Surface technical constraints and platform dependencies; ensure feasibility and reuse.

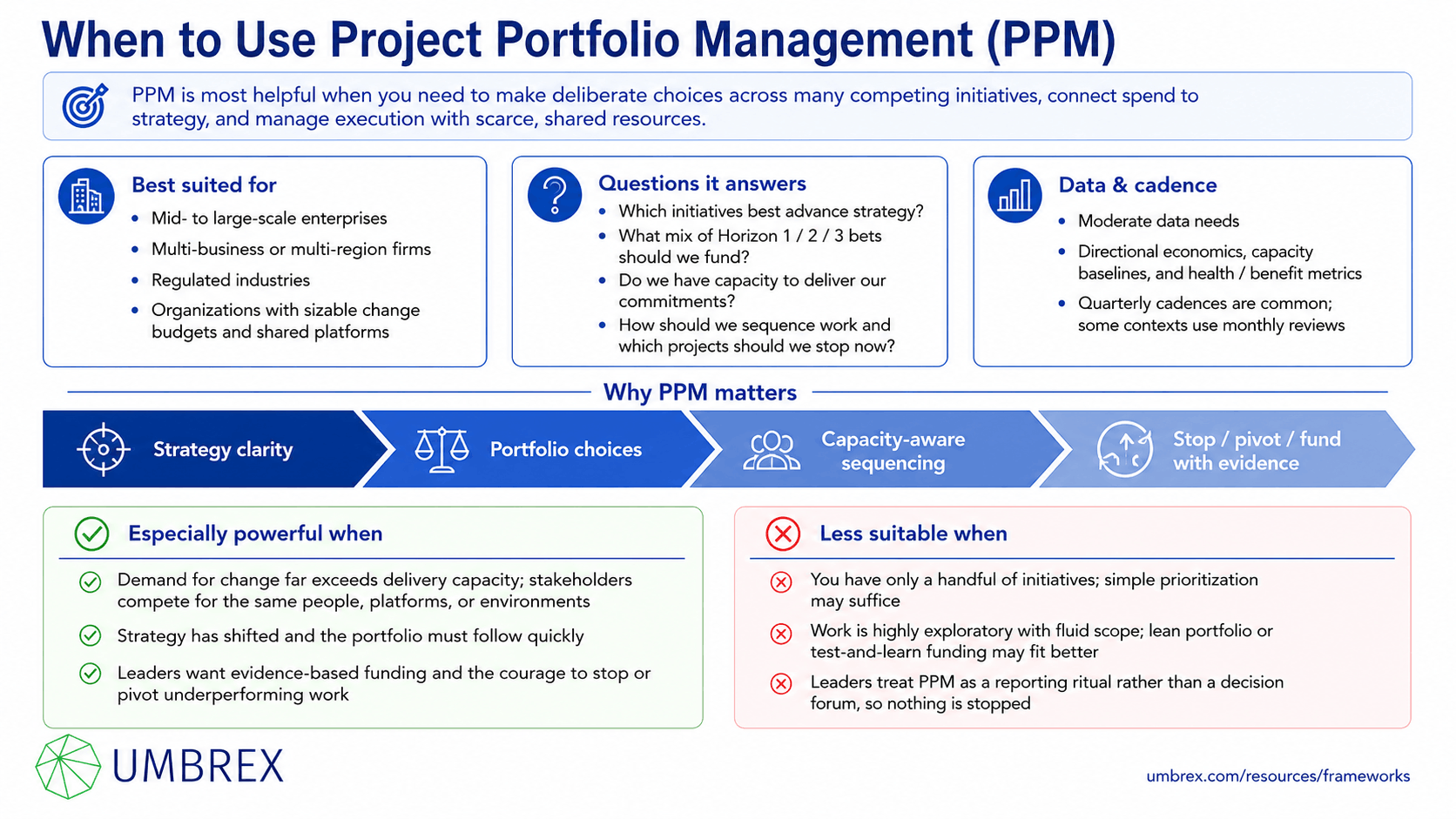

4. When to Use Project Portfolio Management (PPM)

Project Portfolio Management (PPM), specifically when to apply this framework, including portfolio governance, strategic planning, capital investment decisions, enterprise project management, digital transformation, resource planning, and organizational change initiatives.

PPM is most helpful when you need to make deliberate choices across many competing initiatives, connect spend to strategy, and manage execution with scarce, shared resources.

  • Company types: Mid- to large-scale enterprises; multi-business or multi-region firms; regulated industries; organizations with sizable change budgets (technology, product, operations, M&A integration) and shared platforms.
  • Questions addressed: Which initiatives best advance strategy? What mix of horizon 1/2/3 bets should we fund? Do we have capacity to deliver our commitments? How do we sequence to reduce risk? Which projects should we stop now?
  • Data/time requirements: Moderate. PPM relies on directional economics (not perfect forecasts), capacity baselines for key skills/teams, and simple health/benefit metrics. Quarterly cadences are common; some contexts use monthly.

Especially powerful when:

  • Demand for change far exceeds delivery capacity; stakeholders compete for the same people, platforms, or environments.
  • Strategy has shifted (e.g., new customer segment, platform modernization) and the portfolio must follow quickly.
  • Leaders want evidence-based funding and the courage to stop or pivot underperforming work.

Less suitable or potentially misleading when:

  • You have only a handful of initiatives—simple prioritization may suffice without a full PPM apparatus.
  • Work is highly exploratory with fluid scope; consider Lean Portfolio or product-based funding with small, test-and-learn tranches instead of heavyweight business cases.
  • Leaders treat PPM as a reporting ritual rather than a decision forum (peanut-butter budgeting persists; nothing is stopped).

5. How to Apply Project Portfolio Management (PPM): Step-by-Step

Project Portfolio Management (PPM), specifically how to apply this framework, including identifying and evaluating projects, aligning initiatives with strategic objectives, prioritizing investments, allocating resources across the portfolio, monitoring portfolio performance, balancing risks and returns, and continuously optimizing the project portfolio.

  1. Make strategy and guardrails explicit.

    Define strategic themes and outcomes (e.g., protect core, digitize distribution, expand into X). Translate into portfolio guardrails: funding envelopes by theme/value stream, minimum/maximum allocation by horizon, regulatory must-dos, risk appetite, and capacity constraints (key skills/teams).

  2. Stand up a single intake and taxonomy.

    Create a standard intake form and classification (initiative type, theme, value stream, dependency, regulatory, risk). Route all demand—projects, epics, enhancements—through one funnel. Eliminate shadow queues.

  3. Inventory the current portfolio and free capacity.

    Baseline all in-flight work with spend-to-date, forecast-to-complete, expected benefits, risk, and dependency maps. Identify candidates to stop, pause, or de-scope. Redeploy freed capacity to higher-value bets before adding new starts.

  4. Define a pragmatic evaluation model.

    Score each initiative on strategic fit, value (e.g., directional NPV, cost takeout, revenue lift, risk reduction), urgency (e.g., regulatory deadline), risk/complexity, and dependencies. Keep scoring simple (e.g., 1–5 scale) and calibrate with exemplars. Avoid false precision—use ranges and scenario analysis.

  5. Build capacity views and WIP limits.

    For critical roles/teams (e.g., cloud engineers, actuaries, regulatory SMEs), quantify available capacity and realistic throughput. Set WIP limits to prevent overload; assume effective capacity (accounting for BAU and variability), not theoretical 100% utilization.

  6. Run portfolio scenarios and choose the mix.

    Construct 2–4 scenarios (e.g., “core modernization first,” “growth-heavy,” “balanced risk”). Test each against budget and capacity constraints; review risk concentration and dependency clashes. Select the scenario that maximizes value while meeting guardrails; document what was not selected and why.

  7. Sequence and fund in tranches.

    Lay out start/finish windows, dependencies, and key decision points. Release funding in stages tied to evidence (e.g., architecture validated, MVP adoption, benefit realization). Shift from annual big-bang approvals to quarterly/rolling decisions.

  8. Enable execution: align teams, platforms, and vendors.

    Confirm team assignments and vendor capacity; resolve environment and tooling bottlenecks; publish a dependency map. Where possible, move from project-based staffing to persistent, product/value-stream teams with clear backlogs and capacity-based planning.

  9. Install portfolio governance and metrics.

    Establish a cadence (e.g., monthly health, quarterly re-balance). Track a small set of metrics: delivery health (scope, schedule, spend), outcome health (benefits realized vs. plan), capacity/flow (throughput, WIP), and risk (top dependencies, regulatory milestones). Make “stop/pivot/continue” calls explicit.

  10. Rebalance regularly and communicate transparently.

    Update scenarios with new data (market signals, velocity, capacity shifts). Reallocate funding and capacity accordingly; publish a clear rationale for trade-offs. Keep a visible backlog of deferred ideas to maintain trust.

6. Example: PPM in Action

Context: A $8B multi-line insurer ran ~180 technology and business change initiatives across distribution, claims, and finance. On-time delivery hovered at 62%; many projects competed for the same data and integration teams. Strategy called for digitized distribution and core platform modernization, but spend was fragmented and benefits lagged.

Applying PPM:

  • Strategy and guardrails: The executive team set three themes (Digitize Distribution, Claims Excellence, Finance Control) with funding envelopes and a cap on simultaneous core-platform efforts. Regulatory items were non-negotiable but sequenced.
  • Inventory and triage: In-flight portfolio was baselined; 23 initiatives were stopped or merged (low value, duplicative scope). ~12% capacity was freed within six weeks.
  • Evaluation and scenarios: A scoring model combined strategic fit, NPV, risk, urgency, and dependencies. Scenarios tested capacity constraints in data engineering and integration. The chosen mix reduced in-flight initiatives by 28%, prioritized distribution MVPs and two phased core journeys, and deferred lower-value enhancements.
  • Funding and execution: Funding shifted to quarterly tranches tied to evidence (e.g., validated architecture runway, adoption metrics). Portfolio Kanban tracked intake-to-delivery, with WIP limits for the integration platform. Vendor capacity was reallocated to the prioritized themes.

Outcomes (four months): On-time delivery rose to 85%; average time-to-start for approved initiatives dropped by 40% due to reduced contention. Within nine months, the first distribution MVP increased digital quote-to-bind by 7 points; claims straight-through processing improved 6 points. Finance validated $42M annualized benefits versus baseline, stemming from cost-out, uplift, and stopped work. The organization maintained a visible “not doing now” list to reinforce focus.

7. Strengths and Limitations

Strengths

  • Strategy-to-execution linkage: Provides a clear line of sight from strategic themes to funded work and outcomes.
  • Value focus under constraints: Forces explicit trade-offs to maximize value with limited budget and capacity.
  • Transparency and governance: Creates a single source of truth for what’s approved, in-flight, deferred, and why.
  • Agility at the portfolio level: Regular rebalancing enables pivot/stop decisions as new information emerges.
  • Dependency and capacity management: Reduces friction and delays by sequencing around real bottlenecks.

Limitations

  • Risk of bureaucracy: If over-engineered, PPM becomes a reporting exercise; decision velocity slows.
  • Forecast uncertainty: Early business cases can be wrong; treat them as directional, not precise commitments.
  • Cultural resistance: Stopping work and enforcing WIP limits require leadership courage and behavior change.
  • Doesn’t replace product discovery: PPM prioritizes investment; it does not guarantee solution-market fit—teams still need Lean/Agile discovery practices.

8. Common Pitfalls (and How to Avoid Them)

  • Peanut-butter funding.
    What goes wrong: Budgets spread thinly across many initiatives; nothing finishes.
    How to avoid: Concentrate funding on the top priorities; enforce WIP limits; maintain a visible backlog of deferred work.
  • Scoring theater.
    What goes wrong: Complex models yield spurious precision; decisions still made by opinion.
    How to avoid: Use a simple, calibrated scoring model plus scenario analysis. Keep a narrative of trade-offs alongside the numbers.
  • Ignoring capacity constraints.
    What goes wrong: Approvals outpace delivery; teams context-switch and slow down.
    How to avoid: Baseline effective capacity for scarce roles; limit starts; sequence to reduce contention.
  • Sunk-cost bias.
    What goes wrong: Underperforming projects continue because they are “70% done.”
    How to avoid: Review by forward-looking value and evidence; normalize stopping; redeploy capacity quickly.
  • Dependency blindness.
    What goes wrong: Initiatives block one another; schedules slip invisibly.
    How to avoid: Maintain a live dependency map; assign owners; prioritize integration/platform readiness early.
  • Annual plan rigidity.
    What goes wrong: Static once-a-year choices; portfolio drifts from strategy as conditions change.
    How to avoid: Rebalance quarterly; fund in tranches; allow entry/exit based on evidence.
  • Benefits attribution gaps.
    What goes wrong: “Delivered on time/on budget” but no measurable outcomes.
    How to avoid: Assign benefit owners; define baselines and measures up front; track realization post go-live.
  • Tool-first adoption.
    What goes wrong: Implementing PPM software without decision-process clarity.
    How to avoid: Design governance and cadences first; use tools to enable, not dictate, process.

9. How PPM Relates to Other Frameworks

  • Corporate portfolio tools (e.g., GE–McKinsey 9-box): Those evaluate business units or product lines; PPM manages change initiatives within or across those businesses. Use together: corporate portfolio sets where to play; PPM funds how to execute.
  • Strategy deployment (Hoshin Kanri) and OKRs: Translate strategy into targets; PPM allocates funding and capacity to the initiatives that deliver those targets. Align quarterly OKRs with portfolio rebalancing.
  • Stage-Gate/New Product Development: Stage-Gate manages product projects through phases; PPM chooses which product projects to fund and when. Use PPM to shape the product development pipeline.
  • Agile/Lean Portfolio Management (e.g., SAFe LPM): Agile focuses on team-level iteration; Lean Portfolio Mgmt adds portfolio-level flow and guardrails. PPM and LPM are complementary; many enterprises blend them—PPM for funding and governance, LPM for cadence and flow.
  • Program and Project Management (PMBOK/PRINCE2): Run delivery for approved work. PPM sits upstream (selection, funding) and oversees downstream (health, benefits).
  • Financial methods (NPV/DCF, real options): Provide valuation inputs; PPM uses them directionally alongside strategic fit and capacity constraints.
  • Theory of Constraints (TOC): TOC helps identify enterprise bottlenecks (e.g., architecture team, test environments). PPM sequences to protect the constraint and maximize throughput.

10. Key Takeaways

  • PPM applies investment discipline to change: choose, fund, and sequence the initiatives that best advance strategy within real capacity and budget constraints.
  • Keep the system simple: a single intake, calibrated scoring, visible scenarios, and quarterly rebalancing are more valuable than complex models.
  • Respect constraints and dependencies; enforce WIP limits to convert approvals into delivered outcomes.
  • Shift from annual, project-based funding to rolling, evidence-based tranches tied to outcomes and learning.
  • PPM complements strategy deployment, Agile/Lean portfolio practices, and program/project management to create a closed loop from strategy to realized benefits.

11. FAQs About Project Portfolio Management (PPM)

Is PPM still relevant in Agile organizations?
Yes. Agile accelerates delivery at the team level; PPM decides which initiatives to fund and how to sequence them across shared constraints. Many organizations adopt Lean Portfolio practices within a PPM governance wrapper—quarterly tranches, capacity-based planning, and outcome-based steering.

What’s the difference between a PMO and PPM?
A PMO typically focuses on delivery standards, reporting, and support for projects/programs. PPM is the decision framework for selecting and funding the right work, sequencing it, and rebalancing the mix. Some PMOs evolve into “Value Offices” that own PPM alongside delivery enablement.

How long does it take to implement PPM?
A pragmatic PPM capability can stand up in 8–12 weeks: single intake, basic scoring, capacity baselines for scarce roles, portfolio Kanban, and a quarterly review cadence. Maturing benefits tracking and rolling funding usually takes 3–6 months.

Do we need specialized tools?
Not initially. You can start with spreadsheets and collaboration tools if governance is clear. As scale and complexity grow, PPM platforms help with scenarios, capacity planning, dependencies, and reporting. Tools enable—governance decides.

How do we handle regulatory “must-do” work vs. growth initiatives?
Segment the portfolio: ring-fence capacity/funding for immovable regulatory items (prioritized by risk and deadline), then optimize the discretionary mix. Where possible, bundle compliance with modernization to capture incremental value.

Can small organizations use PPM?
Yes—lightly. With 5–15 initiatives, a simple quarterly prioritization workshop, visible roadmap, and capacity check is sufficient. Add sophistication only as demand and interdependencies increase.

How do we ensure benefits are realized?
Assign benefit owners, define baselines and measures up front, link tranches to evidence, and track realization post go-live. Review benefit performance at each quarterly portfolio check; stop or reshape work that isn’t paying back.

How to get started

1

arrow-down-blue

Tell us about your project

2

arrow-down-blue

Interview candidates

(We’ll provide bios within 48 hours on average)

3

Select your consultant and start work

Find a Consultant

or email us at: [email protected]
