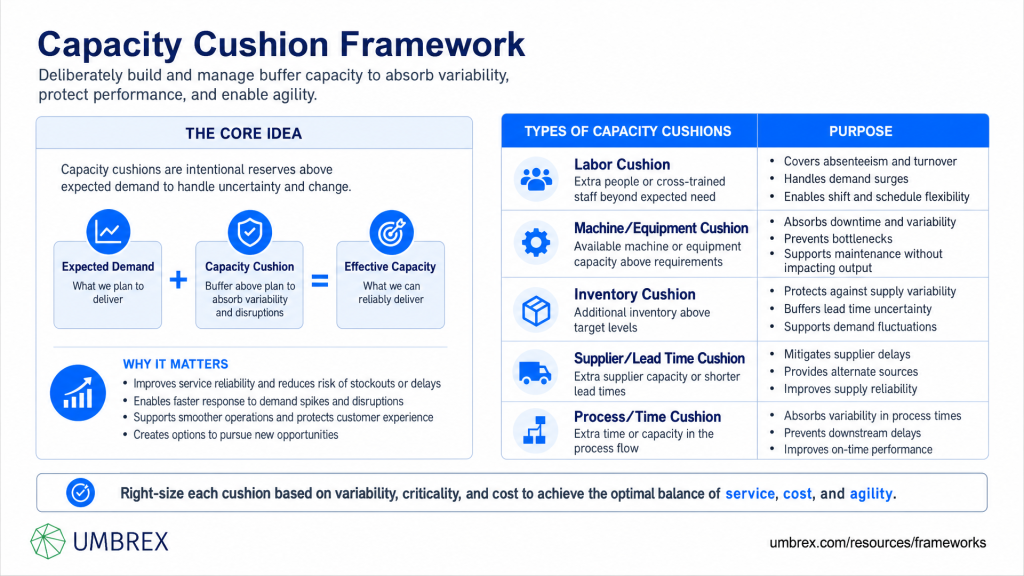

Capacity Cushion Framework

Capacity Cushion Framework

Capacity Cushion Framework - Umbrex Frameworks

1. What Is Capacity Cushion Framework?

The Capacity Cushion Framework is an operational planning tool used to decide how much spare capacity an organization should keep above expected demand. In plain terms, it helps leaders answer a practical question: how close to full should we run our people, equipment, facilities, or service channels without creating unacceptable delays, stockouts, overtime, or service failures?

It is best understood as an operations and capacity-management framework. Rather than aiming to maximize utilization at all costs, it balances utilization against uncertainty, responsiveness, and resilience. Consultants often use it in broader operations improvement work because it turns a vague debate about “too much slack” versus “too little capacity” into a structured business decision.

The framework is relevant in manufacturing, logistics, healthcare, field services, customer operations, and any setting where demand varies and capacity cannot be adjusted instantly or cheaply.

2. Origin and Background

Origin: Unknown; in use since at least the 1980s in operations-management literature and practice.

Capacity cushion is a widely taught concept rather than a branded framework with one universally recognized creator. It appears across operations-management textbooks, university courses, and practitioner discussions of plant loading, staffing, service levels, and production planning. The underlying logic also reflects older ideas from queueing theory and operations economics: when utilization gets too close to 100 percent, waiting times, congestion, and missed commitments tend to rise sharply.

The concept became widely known because it solves a recurring management problem. Executives and operators need a practical way to decide how much reserve capacity to hold in the face of forecast error, seasonality, downtime, absenteeism, changeovers, and disruptions. Capacity cushion gives them a simple planning lens for that decision.

3. How Capacity Cushion Framework Works

At its core, the framework compares effective capacity with expected load. Effective capacity is the amount of output a resource can realistically sustain after accounting for real-world constraints such as maintenance, setups, breaks, yield loss, and operating policies. Expected load is the demand or work volume the resource is likely to face over the planning period.

The gap between the two is the cushion. If a line can realistically produce 100 units per day and the plan assumes 85 units, the business is operating with a 15 percent capacity cushion. Said differently, it is choosing to run at 85 percent planned utilization rather than trying to fill every available hour.

The framework becomes useful when management asks not just “what is our capacity?” but “what cushion should we hold, where, and why?” The right answer depends on variability, service expectations, the cost of failure, and how quickly capacity can be added or shifted.

The main building blocks

  • Effective capacity: The practical, usable capacity of a machine, line, team, warehouse, clinic, or service channel.
  • Expected demand or load: The work volume likely to arrive in the relevant period.
  • Target utilization: The share of effective capacity management intends to use under normal conditions.
  • Capacity cushion: The unused share intentionally preserved to absorb uncertainty and peaks.

What determines the right cushion

FactorImplication for cushion
Demand variabilityMore volatile demand usually requires a larger cushion.
Service-level expectationsOperations with tight response-time commitments need more reserve capacity.
Cost of shortfallIf lost sales, penalties, or patient risk are high, under-capacity becomes more expensive.
Flexibility of supplyIf overtime, temp labor, outsourcing, or rerouting are easy, the required fixed cushion may be smaller.
Bottleneck criticalityThe most constrained resource often needs more explicit protection than non-bottlenecks.
Reliability lossesFrequent downtime or yield issues justify a larger practical buffer.

A useful way to think about it

Capacity cushion is not a companywide number. Strong operators set different cushions for different resources, time horizons, and service promises. A bottleneck machine, an ICU bed pool, and a back-office claims team should rarely be managed to the same target utilization. The framework is therefore less about finding one “right” percentage and more about making a deliberate, segmented policy choice.

4. When to Use Capacity Cushion Framework

This framework is most useful when leaders must balance efficiency against responsiveness. Typical applications include plant loading, staffing models, warehouse throughput, transport capacity, clinic scheduling, call-center staffing, and service operations where demand is uncertain and capacity is relatively fixed in the short term.

It is especially powerful inside broader supply chain planning when management needs to decide whether to add shifts, buy equipment, use contract capacity, build inventory ahead of peaks, or accept a certain level of waiting time. It works for both B2B and B2C businesses, and for companies ranging from small owner-operated firms to complex global networks.

To use it well, teams typically need demand history by period, seasonality patterns, forecast error, service-level expectations, cycle times, setup losses, downtime, labor availability, and information on how quickly capacity can be flexed. A lightweight analysis can be done in days, but a robust version across multiple plants or channels often takes several weeks.

The framework is not a good fit when capacity is essentially elastic and inexpensive to scale instantly, or when the unit of analysis is poorly defined. It can also mislead when teams rely on averages and ignore peaks, bottlenecks, or interdependencies. Two operations may have the same average utilization, but the one with lumpy demand and frequent breakdowns needs a very different cushion.

Modern practitioners use the concept somewhat differently from older textbook treatments. Instead of setting one blanket utilization target, they segment by resource and planning horizon, combine the analysis with scenarios and bottleneck logic, and treat cushion as one lever among others such as inventory, pricing, outsourcing, and service differentiation.

5. How to Apply Capacity Cushion Framework: Step-by-Step

  1. Clarify the decision and scope. Define the business question first. Are you setting staffing levels for a service center, deciding whether to add a production line, or determining how much surge capacity to preserve during peak season? Be explicit about the time horizon, the locations or business units included, and the service promise the operation must support.
  2. Gather the required inputs and data. Collect historical demand, forecast error, seasonality, order patterns, cycle times, changeover times, downtime, absenteeism, yield, and current service outcomes. Qualitative inputs matter too: operator interviews, customer escalation themes, and management views on acceptable risk often explain why a mathematically neat answer fails in practice.
  3. Define the units of analysis. Decide what exactly you are sizing. The right unit may be a plant, line, work center, warehouse zone, truck lane, physician specialty, or skill-based labor pool. A common mistake is analyzing the whole business when the real capacity constraint sits in one small but critical step.
  4. Establish the practical capacity baseline. Start from effective capacity, not theoretical maximum. Strip out assumptions that ignore maintenance, training, quality losses, vacations, shift overlaps, or planning inefficiencies. If the baseline is inflated, the cushion will look larger than it really is.
  5. Build the demand-capacity view. Compare expected load with effective capacity by period and by resource. Most teams build a simple model showing baseline demand, peak demand, current utilization, and resulting cushion. Scenario views are helpful: normal case, peak season, disruption case, and downside demand case.
  6. Set target cushions by resource. Do not force one utilization target across the network. Set tentative cushions based on volatility, service sensitivity, bottleneck status, and flexibility options. A noncritical support process may be able to run tight; a bottleneck with long recovery time should not.
  7. Translate the answer into operating rules. A capacity cushion decision should lead to actions such as adding shifts, cross-training labor, using overtime selectively, prebuilding inventory, qualifying backup suppliers, or approving capital spending. In mature organizations, these choices are best embedded in the monthly S&OP process so they can be updated as demand and constraints change.
  8. Test sensitivities and align stakeholders. Stress-test the conclusion against different forecasts, downtime assumptions, absenteeism rates, and service targets. Then socialize the output with finance, operations, commercial leaders, and frontline managers. If they do not trust the assumptions, they will ignore the target cushion no matter how elegant the model is.

6. Example: Capacity Cushion Framework in Action

Situation

A $600 million medical-device manufacturer was missing delivery dates on a fast-growing product family. Commercial leaders argued for more plant investment, while operations insisted total utilization was still below 85 percent. Management needed to know whether the business truly lacked capacity or was simply managing it poorly.

Application

The team applied the Capacity Cushion Framework at the work-center level rather than at the plant level. It examined weekly demand patterns, forecast error, batch sizes, setup losses, quality yield, planned maintenance, and the ability to use overtime or outside processing. The analysis focused on molding, sterilization, and packaging, with sterilization suspected as a hidden bottleneck.

Insights and actions

The plant as a whole appeared comfortable, but the sterilization step was running at roughly 97 percent of effective capacity during peak weeks, leaving almost no cushion. Packaging had far more room, and molding could flex with overtime. The company concluded that its real issue was not aggregate capacity but a resource-specific shortage combined with weak demand forecasting for promotion-driven spikes. It responded by contracting overflow sterilization for peaks, revising batch-release timing, cross-training labor, and creating explicit trigger points for when to prebuild inventory or authorize overtime.

7. Strengths and Limitations

Strengths

  • Makes trade-offs explicit: It forces leaders to discuss the cost of spare capacity versus the cost of delay, lost sales, poor service, or operational firefighting.
  • Simple but powerful: The core idea is easy for executives and frontline operators to understand.
  • Improves resource allocation: It helps direct attention to the resources that truly need protection, rather than spreading investment evenly.
  • Supports better risk management: It creates a structured way to plan for volatility, disruption, and recovery time.
  • Works across industries: The logic applies to factories, hospitals, logistics networks, contact centers, and service businesses.

Limitations

  • It is only as good as the inputs: Poor demand forecasts or unrealistic capacity assumptions can make the answer misleading.
  • It can oversimplify dynamic systems: A single cushion percentage may hide queues, interactions, and variability patterns that matter a great deal.
  • It may encourage false precision: Teams can become overly confident in a target number that is actually based on judgment and assumptions.
  • It does not replace bottleneck analysis: Looking at overall utilization can obscure the true constraint.
  • It says little about implementation: Knowing the right cushion does not by itself tell you whether to solve the problem with labor, inventory, outsourcing, redesign, or capital investment.

8. Common Pitfalls and How to Avoid Them

  • Using design capacity instead of effective capacity. This makes the cushion look larger than reality and leads to overloading. Base the analysis on what the operation can sustain in practice, not on theoretical maximum output.
  • Averaging away peaks. Average monthly demand may look manageable even when weekly or daily spikes break the system. Run the framework at the cadence that matches how the operation actually experiences load.
  • Applying one blanket target. A universal utilization rule is convenient but usually wrong. Segment by resource, bottleneck status, and service criticality.
  • Ignoring variability reduction. Teams sometimes treat extra capacity as the only solution. Also ask whether better scheduling, smaller changeovers, improved reliability, or smoother demand can reduce the need for cushion.
  • Confusing non-bottlenecks with constraints. Spare capacity in one step does not compensate for overload in another. Follow the flow and identify the resource that governs throughput.
  • Treating cushion as waste. Some executives reflexively attack unused capacity. In many environments, a deliberate reserve is the price of responsiveness and resilience.
  • Stopping at analysis. A target cushion matters only if it triggers concrete decisions on staffing, scheduling, outsourcing, inventory, or capital. Define those actions while the analysis is being built.

9. How Capacity Cushion Framework Relates to Other Frameworks

Theory of Constraints

Theory of Constraints helps identify the system bottleneck and manage flow around it. Capacity cushion complements that logic by asking how much reserve the bottleneck and adjacent resources should have. In practice, teams often locate the constraint first and then size the cushion around it.

Queueing theory and Little’s Law

Queueing models explain why waiting times can rise sharply as utilization approaches full load. Little’s Law links work in process, throughput, and lead time. Capacity cushion is the managerial policy expression of that math: it tells leaders how much room to preserve so queues and delays do not explode.

Safety stock and inventory-buffer frameworks

Safety stock protects service levels with inventory; capacity cushion protects them with time and productive capability. They are close cousins. If capacity can flex quickly, less inventory may be needed. If capacity is rigid, the business may need more stock. Good operators choose the lowest-cost mix of inventory buffer and capacity buffer.

Sales and Operations Planning

S&OP is a management process, while capacity cushion is a decision rule inside that process. The framework helps define the operating boundaries; S&OP is the governance mechanism used to review demand, supply, and exceptions over time.

10. Key Takeaways

  • The Capacity Cushion Framework helps decide how much spare capacity to hold above expected demand.
  • Its central trade-off is simple: higher utilization lowers apparent cost, but too little cushion increases delays, failures, and firefighting.
  • It works best when demand is uncertain, service matters, and capacity cannot be flexed instantly.
  • The right cushion is resource-specific; one blanket target across the business is usually a mistake.
  • Use effective capacity, not theoretical maximum, and test the answer against peaks, bottlenecks, and scenario changes.
  • It is a thinking aid, not a mechanical answer; action choices still require judgment.

11. FAQs About Capacity Cushion Framework

Is the Capacity Cushion Framework still relevant today?

Yes. It remains highly relevant, but most organizations now use it as part of a broader planning and resilience toolkit rather than as a standalone textbook calculation. Modern teams apply it by resource, by scenario, and by planning horizon instead of setting one fixed utilization target for the whole business.

What is the difference between capacity cushion and safety stock?

Capacity cushion is spare productive capability; safety stock is extra inventory. Both protect service levels against uncertainty, but they do so in different ways. Businesses often use some combination of the two depending on shelf life, lead time, flexibility, and cost.

Can small or early-stage companies use it?

Absolutely. A small manufacturer, clinic, or service business may not need a sophisticated model, but it still needs a clear view of expected demand, practical capacity, and acceptable service risk. Even a spreadsheet-based version can improve staffing and investment decisions.

How long does it typically take to apply in a real project?

A focused analysis for one site or function can often be completed in a few days to two weeks. A cross-network effort involving multiple plants, channels, or service lines usually takes several weeks because the data, assumptions, and stakeholder alignment are more complex.

What data is needed to use it well?

The minimum useful inputs are historical demand, a forecast, practical capacity, and a definition of the service level you need to achieve. The analysis becomes much stronger when you add forecast error, downtime, absenteeism, setup losses, yield, and information on how quickly capacity can be flexed.

How to get started

1

arrow-down-blue

Tell us about your project

2

arrow-down-blue

Interview candidates

(We’ll provide bios within 48 hours on average)

3

Select your consultant and start work

Find a Consultant

or email us at: [email protected]
